Skip to content
Shavnu
The Sde Dov waterfront: beach and promenade with the former airfield inland, looking south toward Tel AvivPhoto: District records

Tel Aviv's last coastline is being sold right now.

Sde Dov is 1,300 dunams of Mediterranean waterfront, released lot by lot, and most of it is spoken for before it is ever advertised. See every parcel, permit and sold price before the next release.

1938The airfield

Sde Dov opened in September 1938, carved out of the dunes north of the Yarkon while the roads to Lydda were unsafe. Palestine Airways flew from here; the RAF took it in the war; Israel's first air force squadron lifted off from this strip in 1947. The city grew up around it and never quite got over it: a working airport on the most valuable coastline in the country.

In its final full year the little field moved 703,649 passengers, most of them shuttling to Eilat. On June 30, 2019, the last flight departed and the tower went quiet. Only that tower still stands today: the one building the plan preserves.

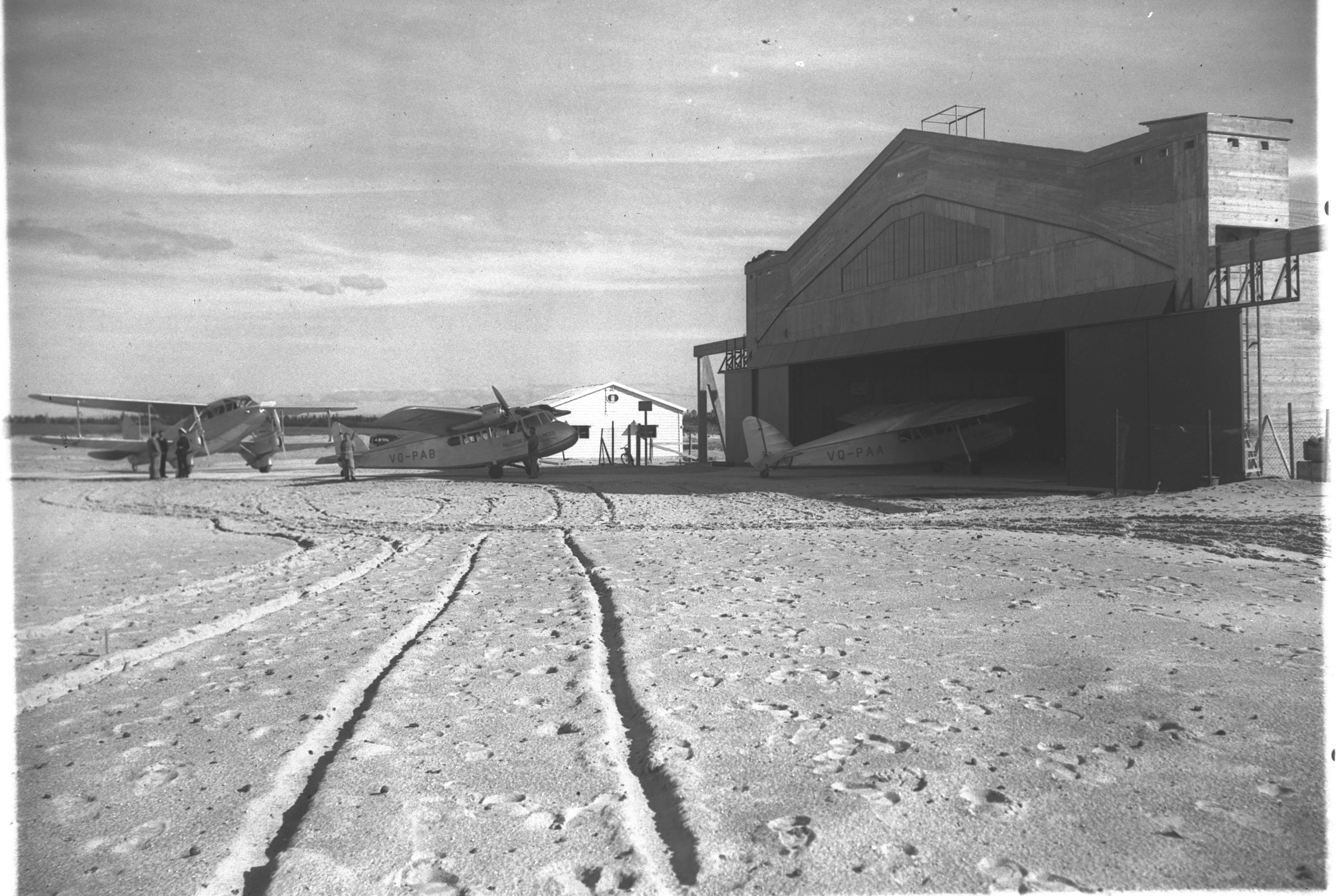

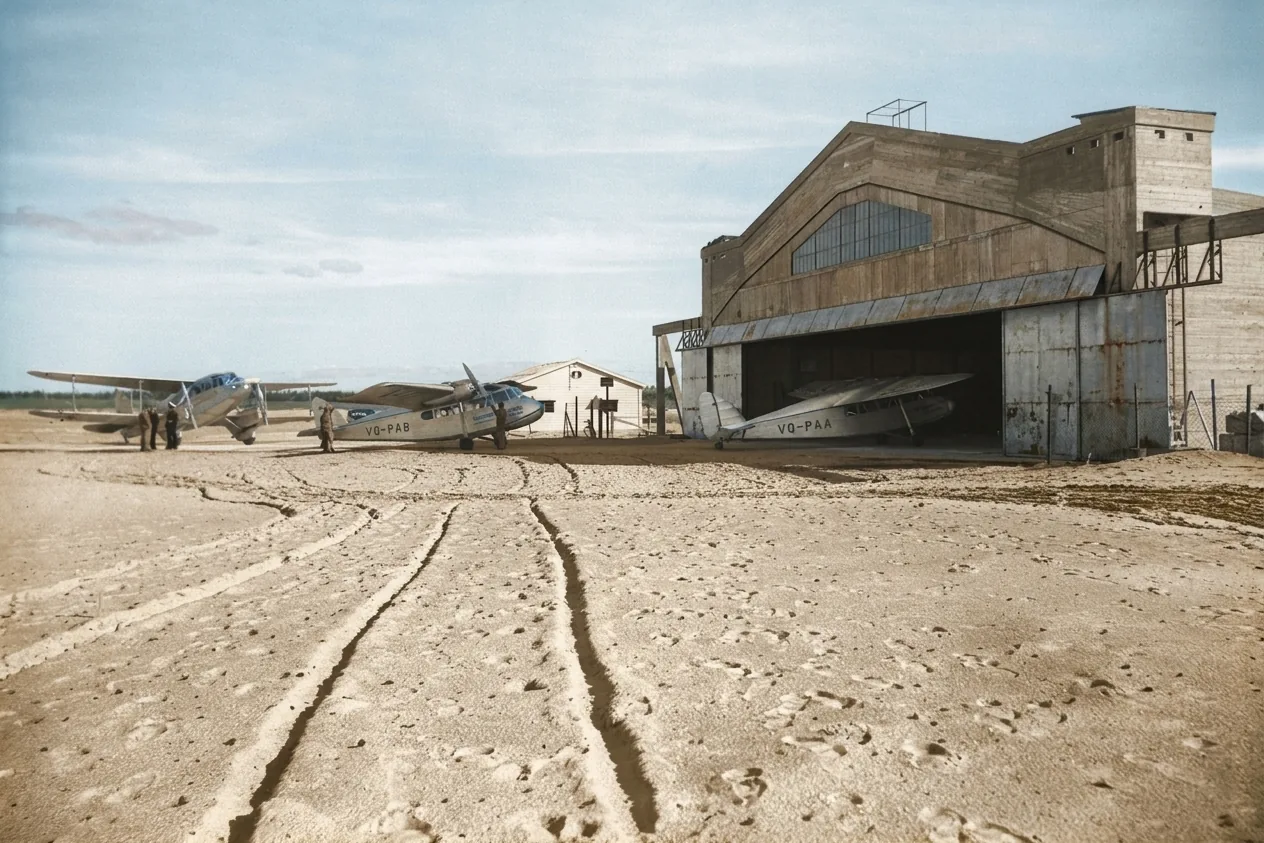

The main hangar, photographed the year the airfield openedZoltan Kluger, Government Press Office · restored and colourised
Final approach over the field, the control tower on the horizonChen Haik / PikiWiki · colour-graded
Night landing: the sea just beyond the threshold lightsOren Peles / PikiWiki (CC BY 2.5) · colour-graded

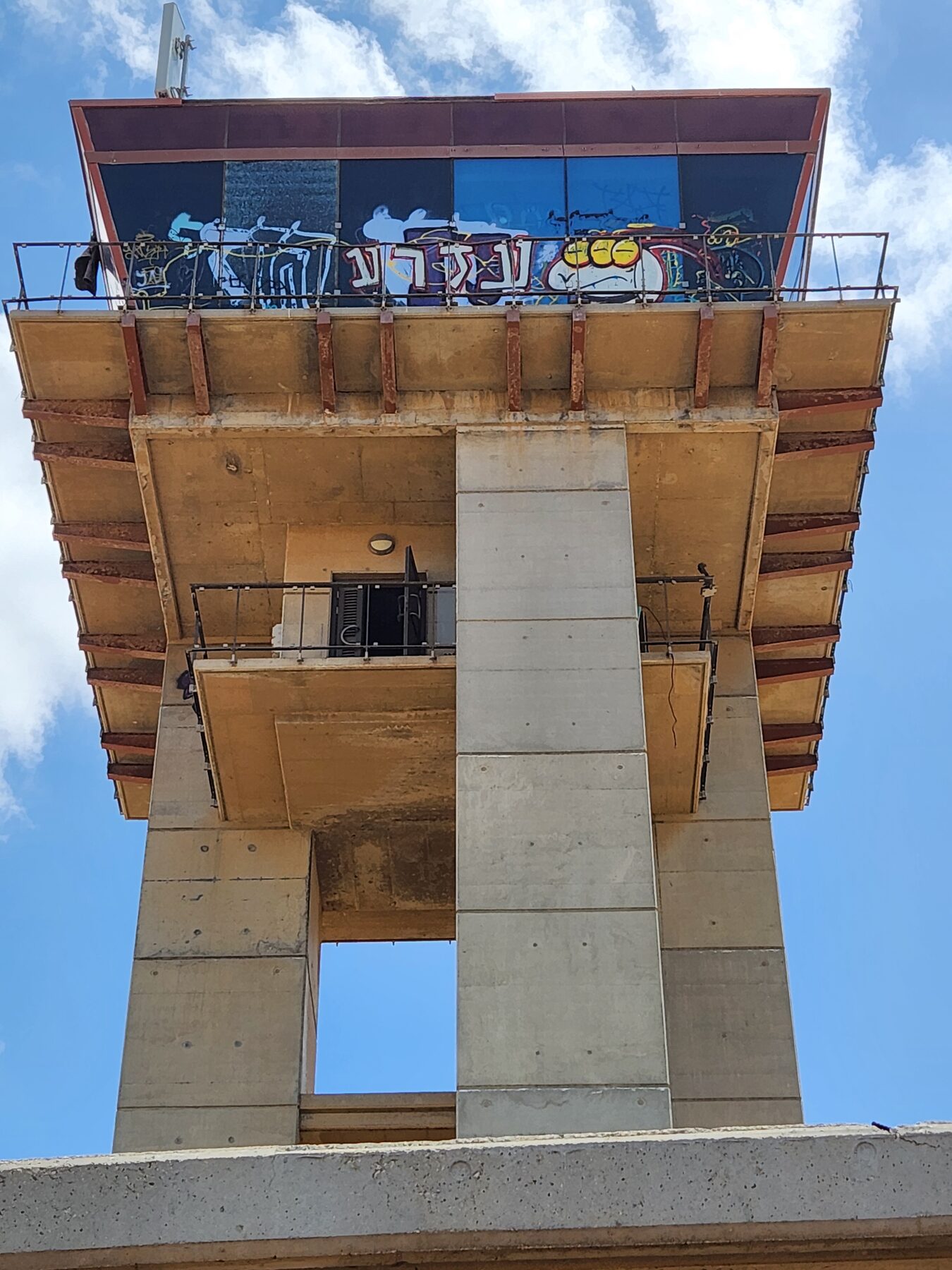

The control tower from below: the one building from the airfield that the plan preservesPikiWiki Israel / Wikimedia Commons

1970sHalf a century of tug-of-war

1,892 owners, one runway.

The land under the runway was never simple. Inside the airport's fence sat "the Big Bloc": famous parcels bought by private families generations ago, 1,892 owners whose rights a court only finished sorting in September 2025. Around them, the state, the city, and the army argued for fifty years about whether planes or people should own this coast.

The government decided in 2012. The Defense Ministry took a billion shekels to leave early, the Supreme Court set the date, and in July 2019 the fence came down. Within a year the runway was rubble and Tel Aviv was staring at something it had never had: an empty, city-sized piece of itself, one row of dunes from the sea.

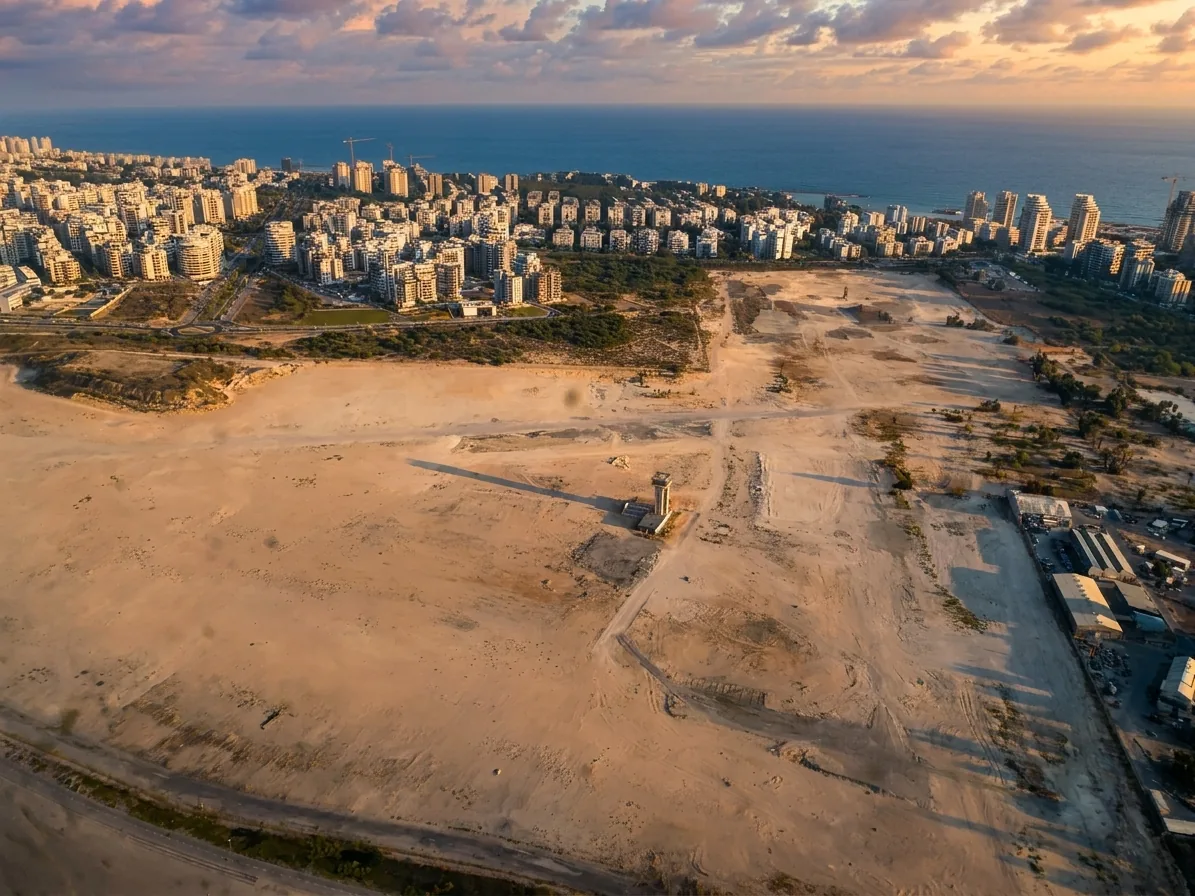

October 2020: the airport erased, the land waitingStas Umansky, Wikimedia Commons (CC) · colour-graded

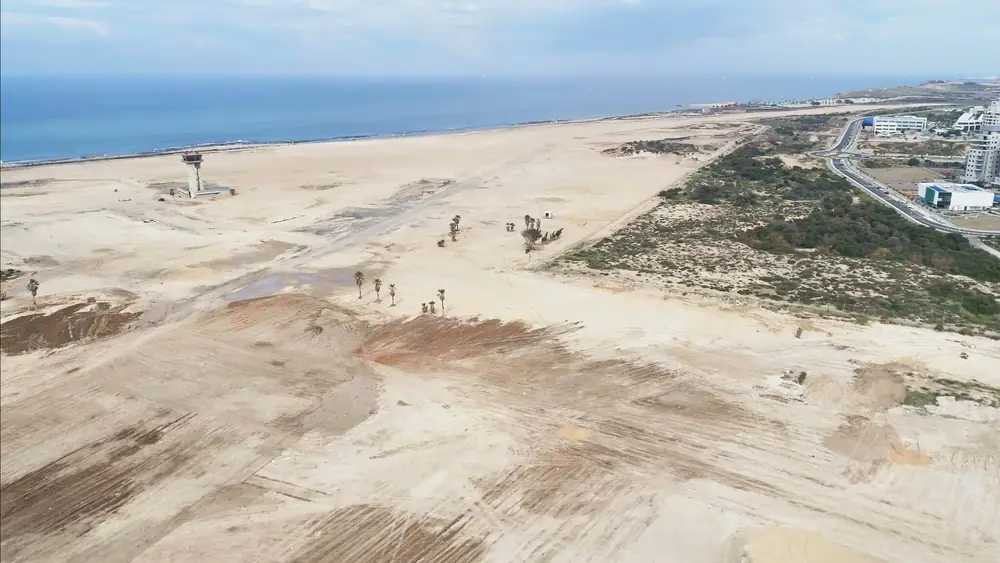

The hangars emptied, February 2020Times of Israel

2020A district drawn from scratch

Masterplan TA/4444 has been in force since August 2020, and it is not a housing estate. It is a full district drawn at once, the way planners dream and cities rarely allow. Sixteen thousand homes in three complexes. Half a million square meters of schools and public buildings. Offices, shops, around 3,000 hotel rooms, and almost a third of the ground given to parks.

Towers stand back from the water behind low "fabric" buildings of seven to nine floors, so the street stays human and the skyline steps up as you walk inland. The old runway becomes Runway Park. The Green Line light rail crosses the district with four stations. Even the garbage is planned: pneumatic pipes instead of trucks.

complexes, Eshkol, Central, North
3complexes, Eshkol, Central, North
dunams of public space
~480dunams of public space
light-rail stations on the Green Line
4light-rail stations on the Green Line
hotel rooms planned
3,000hotel rooms planned
sqm of public buildings
500Ksqm of public buildings
floors, low streets to landmark towers
7-45floors, low streets to landmark towers

Sources: Plan TA/4444 program figures, Tel Aviv-Yafo municipality and district-plan documents, via district records.

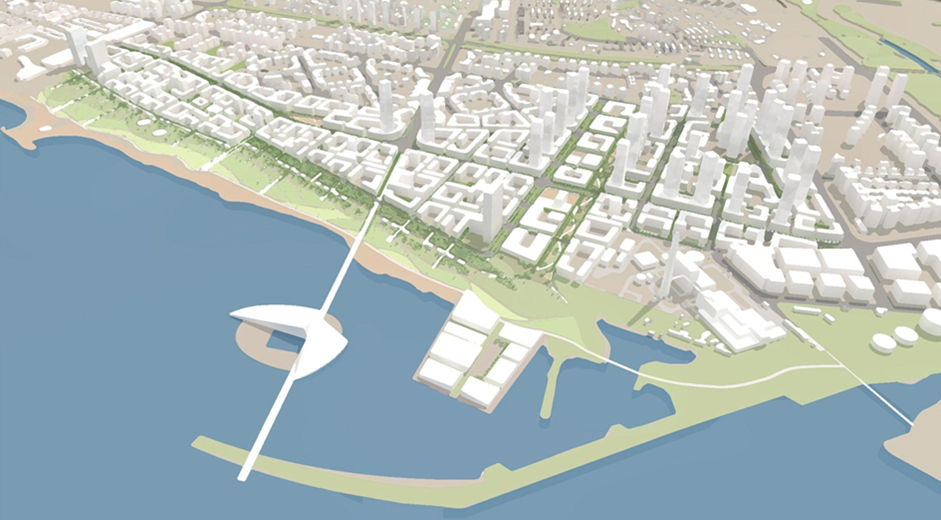

The masterplan: Eshkol south, Central, and North along two kilometers of coastPlan TA/4444, via district records

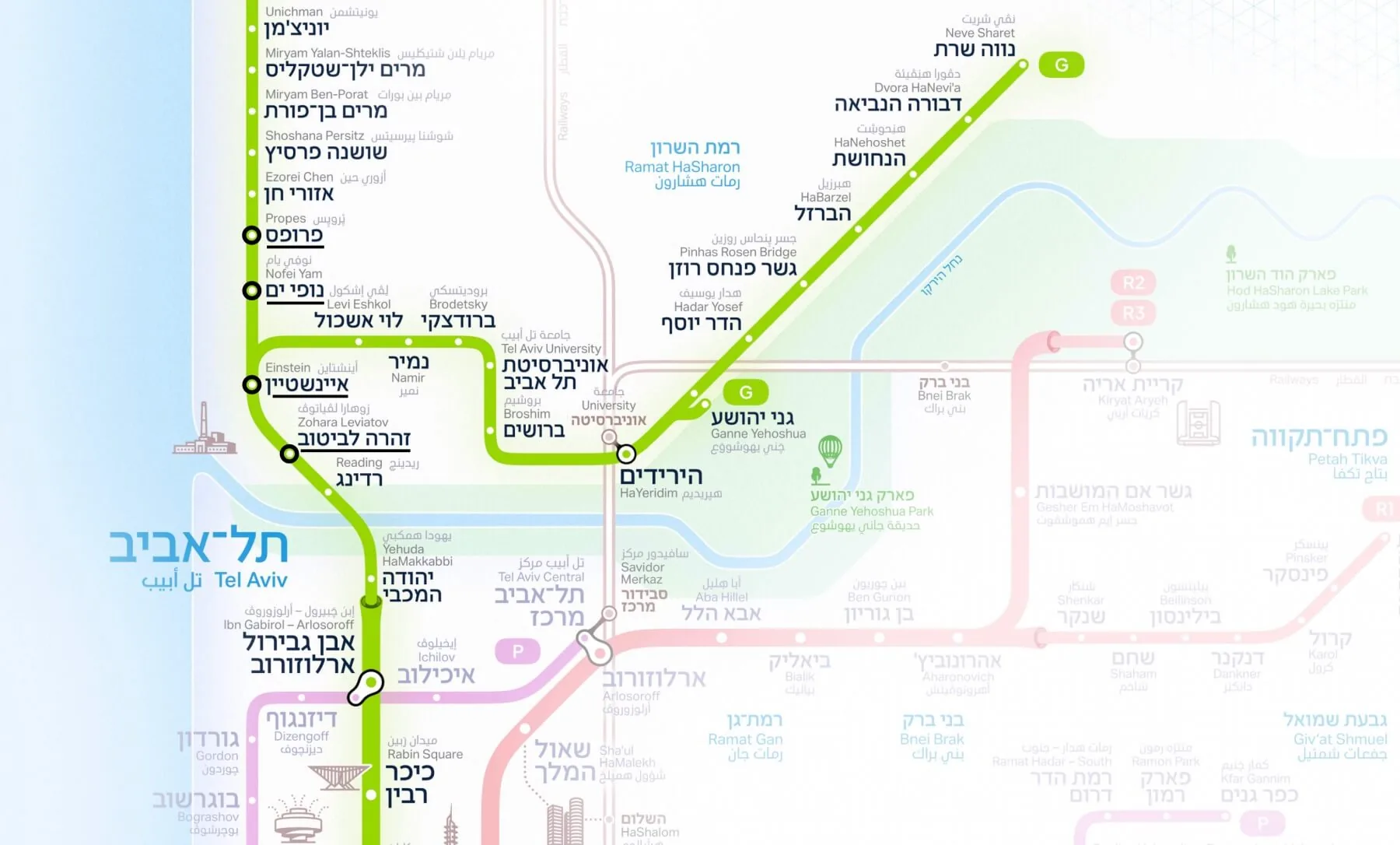

Four light-rail stations: Propes, Nofei Yam, Einstein, Zahara LevitovNTA

2021The most expensive dirt in Israel

When the state finally auctioned the first lots in 2021, developers paid ₪4.4 billion for the right to build 1,540 homes: about ₪2.8 million per apartment before a shovel touched the ground, six and a half times the minimum price. Then came the biggest residential tender wave in Tel Aviv's history: land for more than 7,100 homes offered in one push in September 2024.

The 2025 winners paid roughly forty percent less per home than the 2021 record: a rare, honest repricing of the country's most wanted address. Israel Canada, Gindi, Dimri, Hagag, Dan, Melisron, Tshuva: nearly every major name in Israeli real estate now holds a piece of the field.

2021
₪4.4B
first tender: 1,540 homes, 6.5× the minimum price
2022
₪654M
follow-up tender cools: 241 homes
2024
7,159
homes offered in one mega-tender wave
2025
−40%
land price per home vs. the 2021 record

Sources: Israel Land Authority tender results via Globes, Ynet, Nadlan Center.

NOWRising now

The first cornerstone was laid in November 2024, and the southern complex is now a forest of cranes. Rainbow's tower is climbing under Ashtrom's cranes. ASHIRA holds a full building permit. UTOPIA broke ground in October 2025. Sales run hot and cold (a ₪19.5 million penthouse here, a pricing war there), and in February 2026 the site delivered its hardest news yet: PFAS contamination in the groundwater, a legacy of decades of firefighting foam, now under a state-run cleanup fast track.

We tell that part too. This site is not selling you a render; it is tracking a district being born, permit by permit, with sources on every number. First residents are expected around 2029. The last crane leaves sometime after 2035.

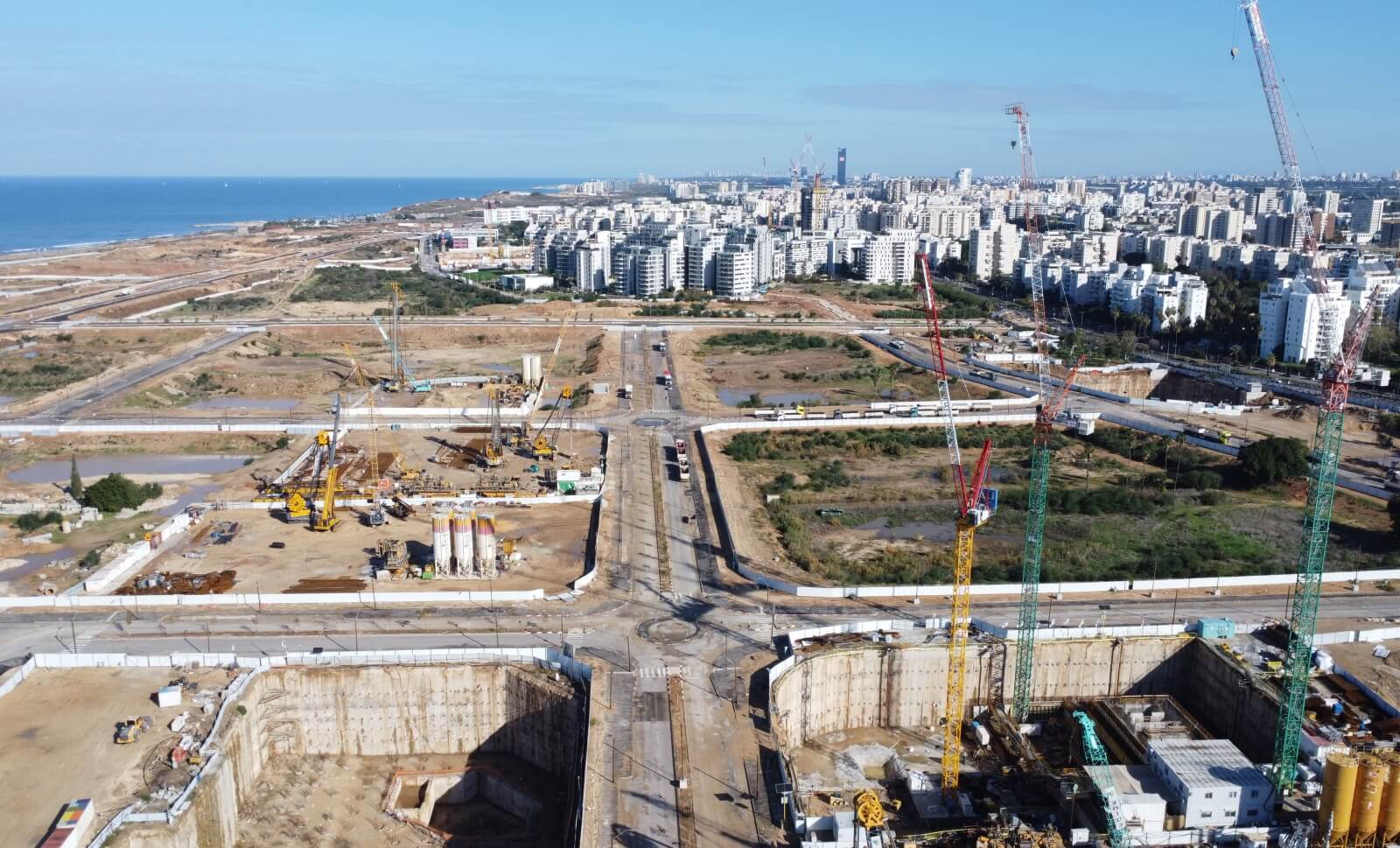

The Eshkol complex under construction, January 2026Photo: District recordsPhoto: Stas Umansky / Wikimedia Commons, modified

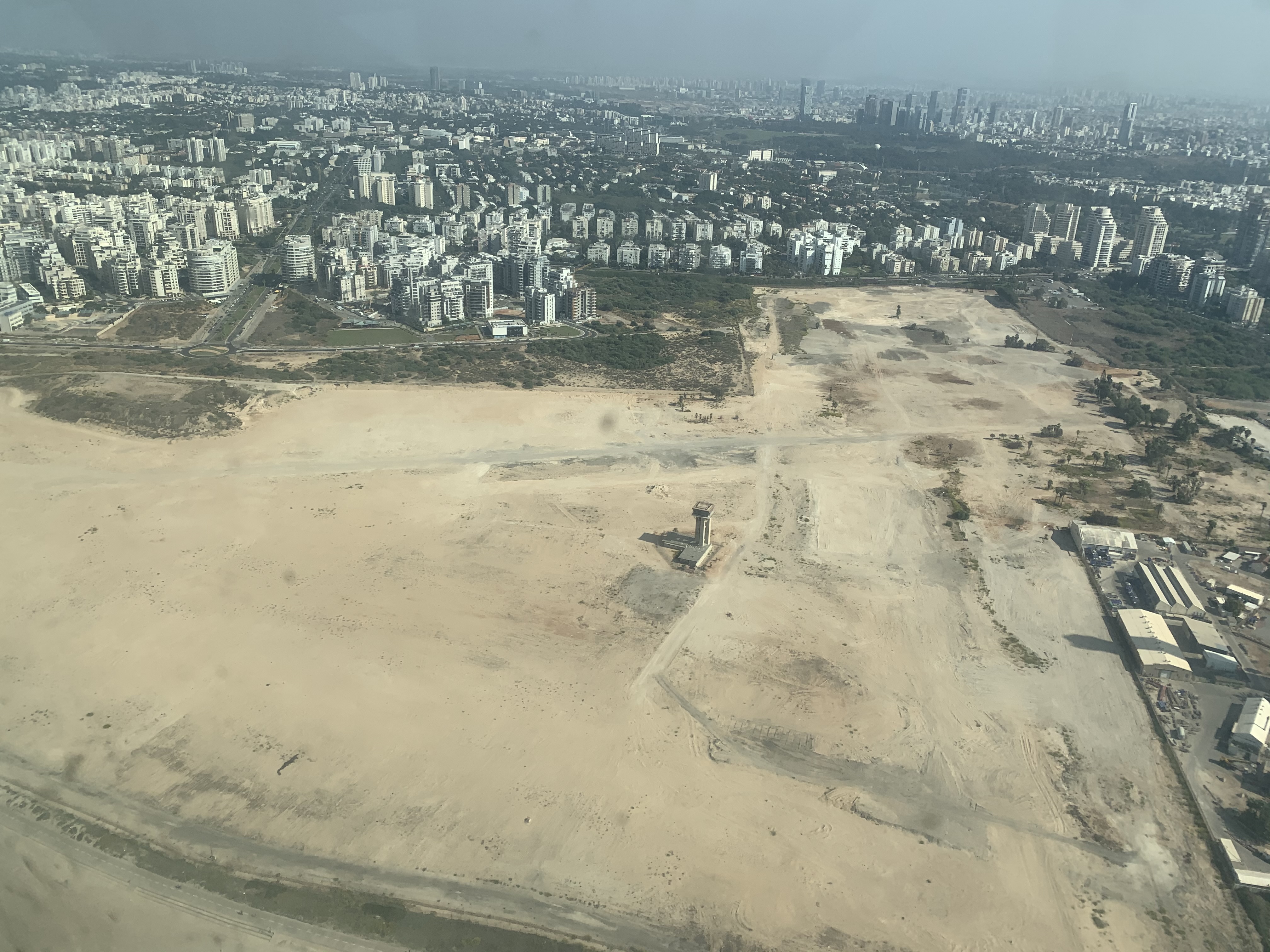

The cleared Sde Dov airport site, October 2020

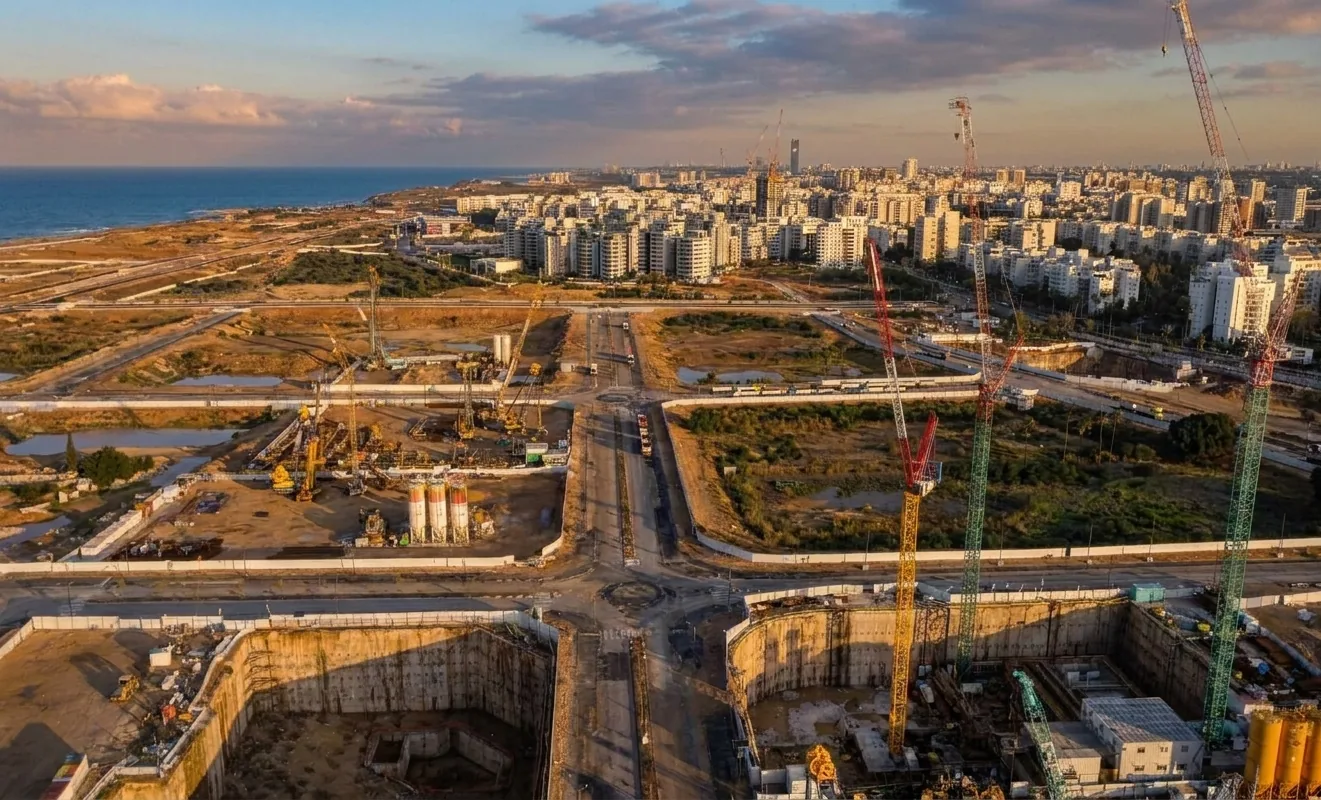

2020: cleared2026: rising
2020: cleared2026: rising
Drag divider: the same ground, six years apartStas Umansky, Wikimedia Commons (CC) · colour-graded · District records

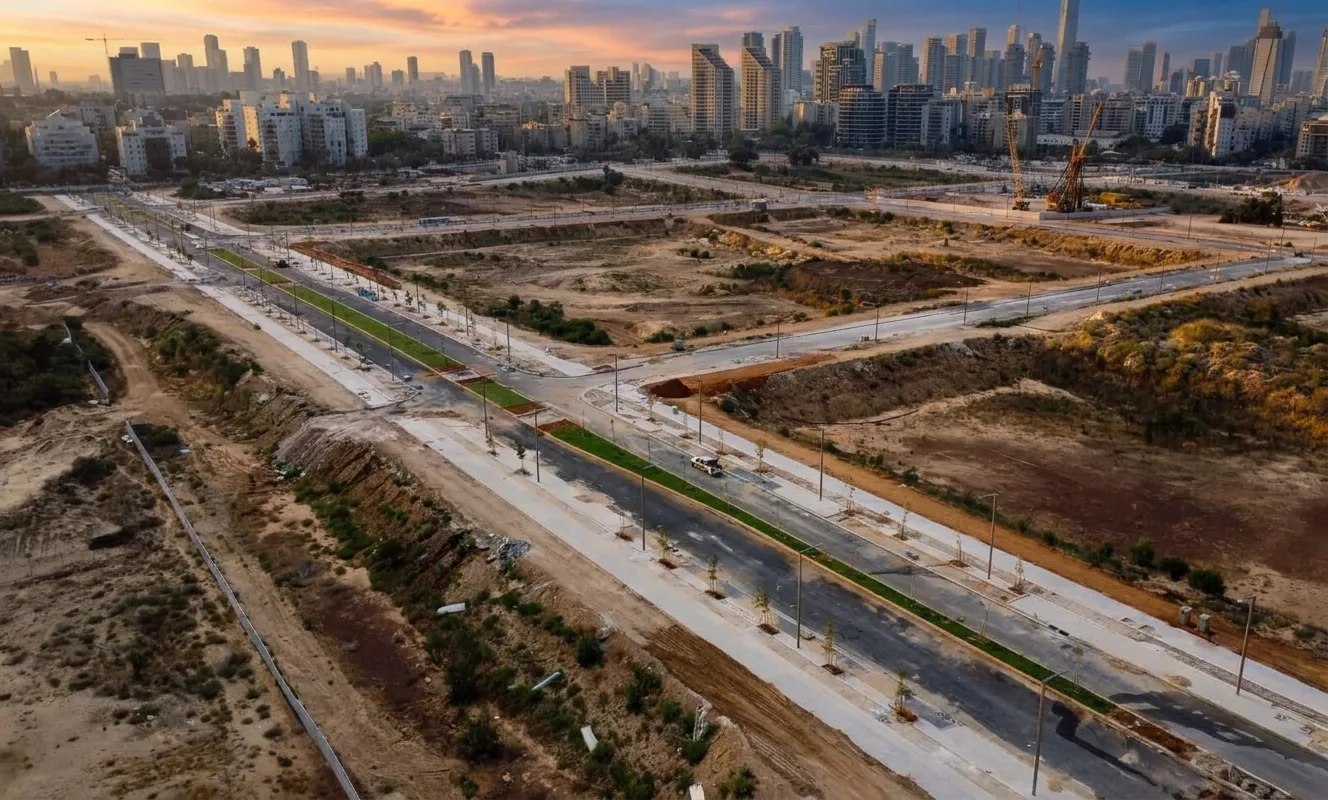

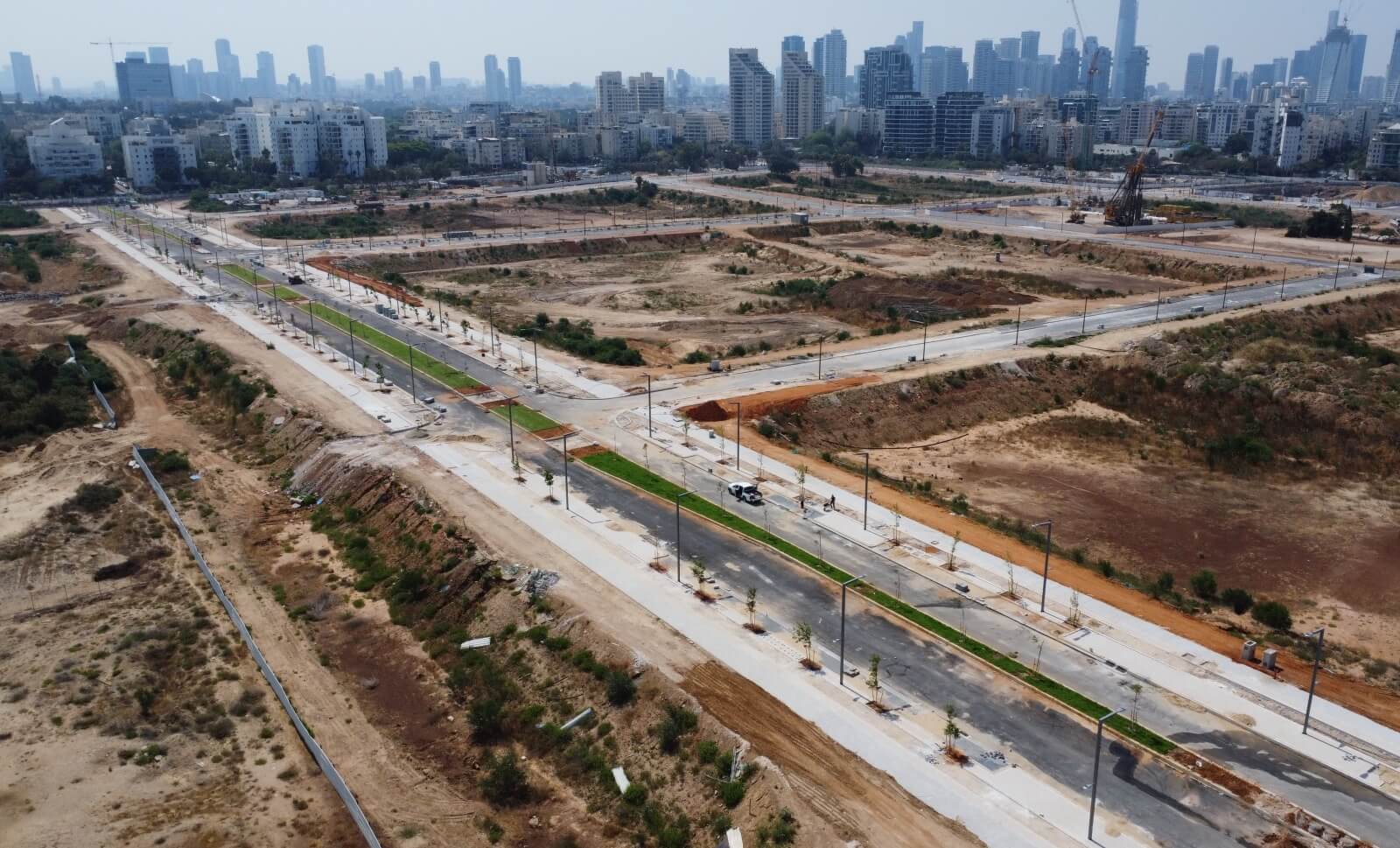

Streets first: Eshkol infrastructure worksDistrict records

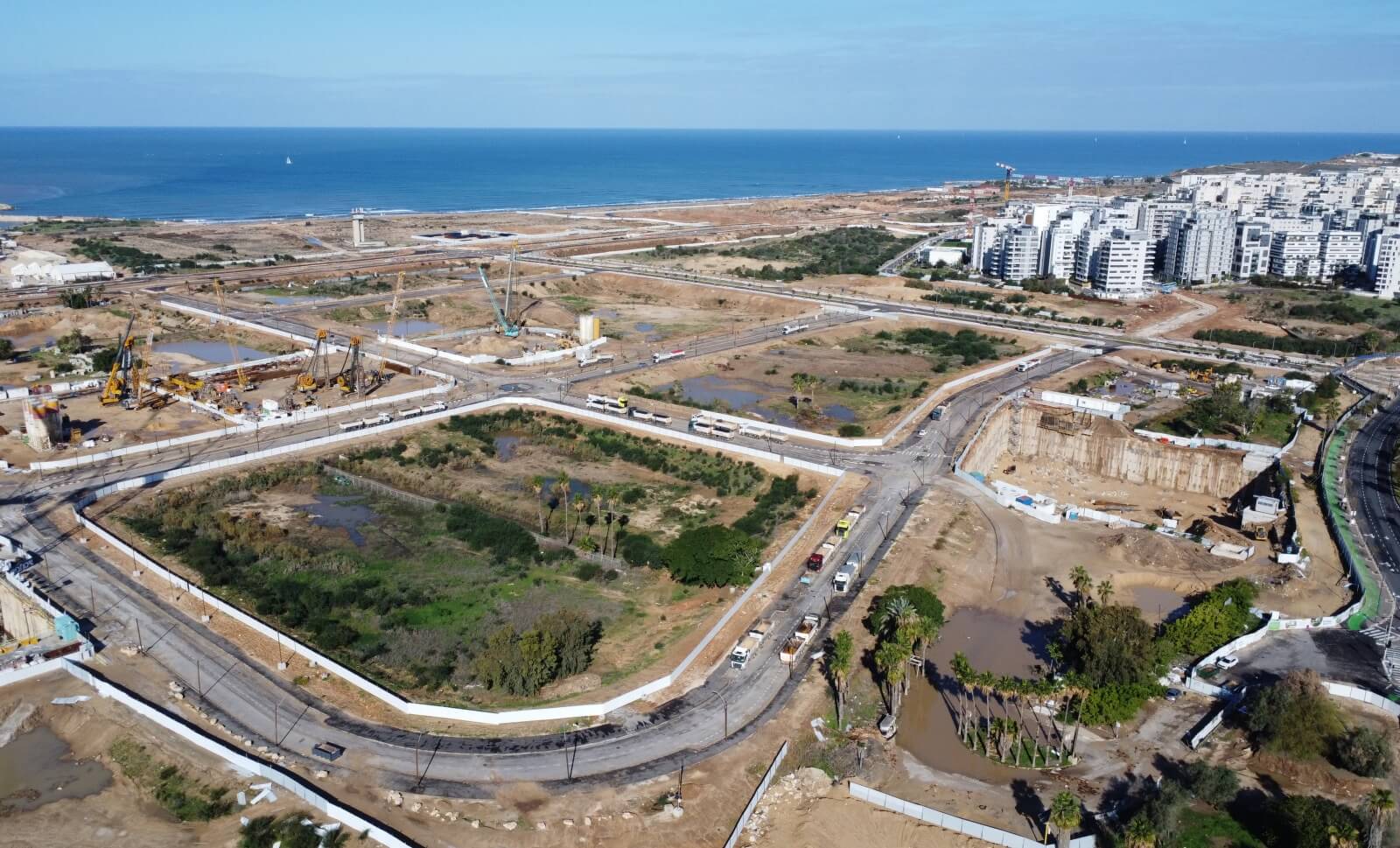

Eshkol's first towers out of the groundDistrict records

NOW9 projects are already on the field.

The ones you can actually inquire about, with a source on every figure.

All projects and lots

TODAYAs it happens.

Sourced Hebrew coverage, translated, when something on the field actually moves.

All news

2029The flight path lands at the terminal.

The map, every parcel, every recorded sale, every permit, the evidence behind this page, with a source on every number.

Open the Terminal
ARRIVALS
SDV · TLV
  • 2029First residentsScheduled
  • —Cadastre parcels mapped—
  • —Recorded sold deals—
  • —Construction sites tracked—

Interested in a specific project?

Tell us which one, and what you are looking for. We are an independent guide to the district, and we answer by email unless you ask otherwise.

Buyer's guides
